Iran Construction Engineers
Civil Engineering Team
A leader in the design and implementation of the latest and the most innovative engineering methods

Building Construction Assessment



At ICE, we are with you from the early stages of land evaluation to the final project delivery. Our expertise ensures you are fully informed about all possible alternatives and aspects of your project, helping you choose the ideal option. These stages include land evaluation, property purchase, economic assessment, determination of optimal use, design, obtaining permits, and construction.



For decades, we have been passionately perfecting our craft throughout Iran. We are dedicated to building structures and take pride in the quality of our work. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. We bring technical knowledge, experience, and resourcefulness to the delivery of our construction services.

What we do

Feasibility Study
A benefical construction is assessed to provide the beset profit for you
Always by your side
We are with you for every stages of building construction

General Procedure of a Construction Assessment

Phase zero: Initial property evaluation


  • Project location – satellite image of the location
  • Land position - based on aerial mapping (provided by mapping organization)
  • The location of the land in the municipal areas - the access roads of the surrounding highways and municipal areas
  • The environmental location: environmental issues
  • Climatic condition: architectural and structural design issues
  • Important urban centers adjacent to the project assessment in order to find suitable building applications
  • Suitable urban characteristics
  • Suitable characteristics of the land
  • Appropriate dimensional specifications: shape and land area
  • Suitable regional location:
  • The future landscape of region development Compared to other urban areas of the city
  • The residential texture of the area: residential, high residential density, etc.
  • Level of culture and income of regional residents
  • SWAT table of the strengths and weaknesses of the plan's position

Phase one: First stage: urban studies and regulations


  • Technical feasibility of the plan
  • Rules and regulations in the construction of buildings
  • Priorities for the construction of high-rise buildings
  • Evaluation rules and regulations of building construction to determine the possible options for the construction of the project
  • Area of use, the number of floors, the total infrastructure, utilities, common areas, parking, etc.
  • Estimating project implementation costs for each of the options

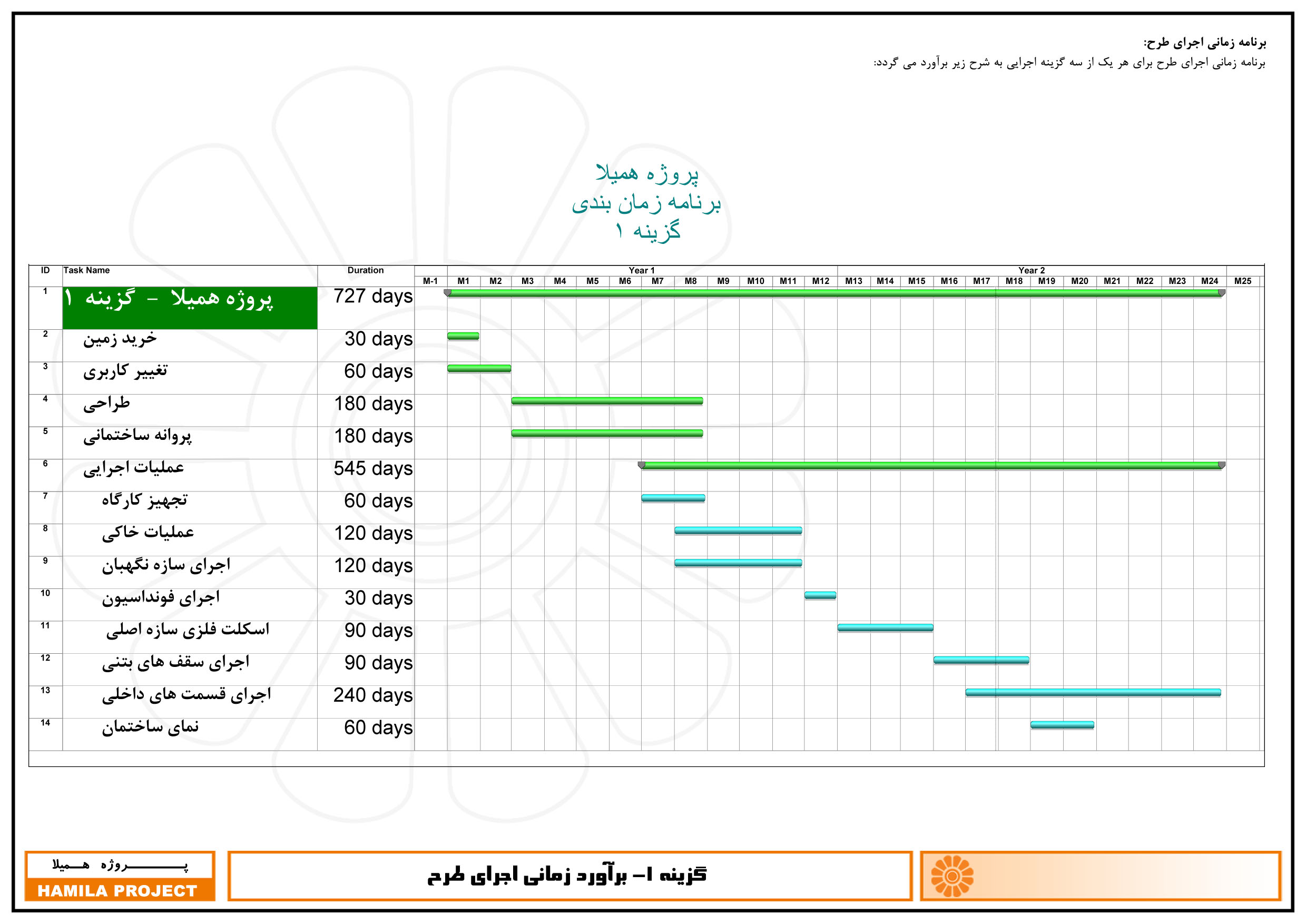

  • Project execution schedule for each of the plan options
  • Economic review of project options
  • Determining the economic options of the plan for economic review (various options)

Phase one: Second stage: technical and economic studies


  • Assumptions of economic modeling and basics of cash flow
  • Sources and expenses table
  • Line graph of cash flow
  • Determination of the head-to-head point
  • Determination of IRR, NPV, PI
  • Financial analysis of the project and determination of the option with the most financial indicators: construction of the project with high-ranking criteria
  • Investigating project risk
  • Matching the options: selling land in the current state, obtaining a license and selling land with the obtained density, and building a project with high-level construction criteria.
  • Sensitivity analysis of the option with the highest financial index: construction of a project with high-ranking criteria
  • Financial and executive scheduling of the project
  • Breakdown table of project implementation costs
  • Financial scheduling - sale of the project
  • Project sale price breakdown table
  • Net inflow - outflow of cash, net comparison table of resources and expenses for all building models
  • Profitability comparison table of building models
  • Chart for determining the profit margin of the models
  • Investigating the effect of increasing building floors on profitability

Phase two: Building design of the project


  • Determining different models of project building design
  • Technical reviews of numerous construction models of the project
  • Economic reviews of numerous construction models of the project
  • The physical plan and structure of the initial formation of the architectural plan
  • Traffic analysis and design of parking lots
  • Summarizing and setting the final table of levels and uses of the architectural plan to be presented to the municipality
  • Making a mockup of the project
  • Mapping
  • Geotechnical studies and soil identification of the project land
  • Soil stabilizer structure design and excavation operation stages
  • Final design

Building Construction Assessment

  • Decades of  of engineering and executive experiences
  • Numerous completed project
  • University corporations
  • Over 1 milion square meters of constructed buildings
  • Experienced and highly educated teams in designings and field operations
Background
ICE Policy

Our projects are well known, and our engineers set us apart. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. ICE brings technical knowledge, experience, and resourcefulness to the delivery of our construction services. Our expertise and value-added offerings support our clients throughout the entire construction process.

We are committed to doing what is right—for our engineers, our clients, our communities, and our planet. We are building today to transform tomorrow through our unwavering commitments

Square Meters of ​Built Infrastructure

Finished projects

Years of Experience

Experties


The ICE
In the ICE, we’re always mindful of ensuring our clients are empowered and informed.
PSS
Prefabricated steel structures (PSS) are similar in construction to conventional in-situ structures, but the parts are manufactured modularly under regulated conditions.
Ocean Engineering
In partnership with Sharif University of Technology, we have been working for many years in designing and constructing marine structures with different applications in Iran.

ICE Group
We are a group of engineers who have been working for many years in designing and constructing buildings with different applications in Iran.
Structural Engineering and Construction
ICE design and implement of the latest and the most innovative engineering
Marine Structures
We provide the offshore and maritime industries with innovative platform design and construction, and engineering services.
Export
Based on the experiences we have gained, we decided to extend our field of activity to other countries and export designed and constructed structures that can be prefabricated.
Iran Construction Engineers

Civil Engineering Team
A leader in the design and implementation of the latest and the most innovative engineering methods

Iran Construction Engineers

Civil Engineering Team
A leader in the design and implementation of the latest and the most innovative engineering methods

Building Construction Assessment



At ICE, we are with you from the early stages of land evaluation to the final project delivery. Our expertise ensures you are fully informed about all possible alternatives and aspects of your project, helping you choose the ideal option. These stages include land evaluation, property purchase, economic assessment, determination of optimal use, design, obtaining permits, and construction.


For decades, we have been passionately perfecting our craft throughout Iran. We are dedicated to building structures and take pride in the quality of our work. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. We bring technical knowledge, experience, and resourcefulness to the delivery of our construction services.

What we do

Feasibility Study
A benefical construction is assessed to provide the beset profit for you
Always by your side
We are with you for every stages of building construction

Building Construction Assessment



At ICE, we are with you from the early stages of land evaluation to the final project delivery. Our expertise ensures you are fully informed about all possible alternatives and aspects of your project, helping you choose the ideal option. These stages include land evaluation, property purchase, economic assessment, determination of optimal use, design, obtaining permits, and construction.


For decades, we have been passionately perfecting our craft throughout Iran. We are dedicated to building structures and take pride in the quality of our work. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. We bring technical knowledge, experience, and resourcefulness to the delivery of our construction services.

Always by your side
We are with you for every stages of building construction
Feasibility Study
A benefical construction is assessed to provide the beset profit for you

General Procedure of a Construction Assessment

Phase zero: Initial property evaluation


  • Project location – satellite image of the location
  • Land position - based on aerial mapping (provided by mapping organization)
  • The location of the land in the municipal areas - the access roads of the surrounding highways and municipal areas
  • The environmental location: environmental issues
  • Climatic condition: architectural and structural design issues
  • Important urban centers adjacent to the project assessment in order to find suitable building applications
  • Suitable urban characteristics
  • Suitable characteristics of the land
  • Appropriate dimensional specifications: shape and land area
  • Suitable regional location:
  • The future landscape of region development Compared to other urban areas of the city
  • The residential texture of the area: residential, high residential density, etc.
  • Level of culture and income of regional residents
  • SWAT table of the strengths and weaknesses of the plan's position

Phase one: First stage: urban studies and regulations


  • Technical feasibility of the plan
  • Rules and regulations in the construction of buildings
  • Priorities for the construction of high-rise buildings
  • Evaluation rules and regulations of building construction to determine the possible options for the construction of the project
  • Area of use, the number of floors, the total infrastructure, utilities, common areas, parking, etc.
  • Estimating project implementation costs for each of the options
  • Project execution schedule for each of the plan options
  • Economic review of project options
  • Determining the economic options of the plan for economic review (various options)

Phase one: Second stage: technical and economic studies


  • Assumptions of economic modeling and basics of cash flow
  • Sources and expenses table
  • Line graph of cash flow
  • Determination of the head-to-head point
  • Determination of IRR, NPV, PI
  • Financial analysis of the project and determination of the option with the most financial indicators: construction of the project with high-ranking criteria
  • Investigating project risk
  • Matching the options: selling land in the current state, obtaining a license and selling land with the obtained density, and building a project with high-level construction criteria.
  • Sensitivity analysis of the option with the highest financial index: construction of a project with high-ranking criteria
  • Financial and executive scheduling of the project
  • Breakdown table of project implementation costs
  • Financial scheduling - sale of the project
  • Project sale price breakdown table
  • Net inflow - outflow of cash, net comparison table of resources and expenses for all building models
  • Profitability comparison table of building models
  • Chart for determining the profit margin of the models
  • Investigating the effect of increasing building floors on profitability

Phase two: Building design of the project


  • Determining different models of project building design
  • Technical reviews of numerous construction models of the project
  • Economic reviews of numerous construction models of the project
  • The physical plan and structure of the initial formation of the architectural plan
  • Traffic analysis and design of parking lots
  • Summarizing and setting the final table of levels and uses of the architectural plan to be presented to the municipality
  • Making a mockup of the project
  • Mapping
  • Geotechnical studies and soil identification of the project land
  • Soil stabilizer structure design and excavation operation stages
  • Final design

General Procedure of a Construction Assessment

Phase zero: Initial property evaluation


  • Project location – satellite image of the location
  • Land position - based on aerial mapping (provided by mapping organization)
  • The location of the land in the municipal areas - the access roads of the surrounding highways and municipal areas
  • The environmental location: environmental issues
  • Climatic condition: architectural and structural design issues
  • Important urban centers adjacent to the project assessment in order to find suitable building applications
  • Suitable urban characteristics
  • Suitable characteristics of the land
  • Appropriate dimensional specifications: shape and land area
  • Suitable regional location:
  • The future landscape of region development Compared to other urban areas of the city
  • The residential texture of the area: residential, high residential density, etc.
  • Level of culture and income of regional residents
  • SWAT table of the strengths and weaknesses of the plan's position

Phase one: First stage: urban studies and regulations


  • Technical feasibility of the plan
  • Rules and regulations in the construction of buildings
  • Priorities for the construction of high-rise buildings
  • Evaluation rules and regulations of building construction to determine the possible options for the construction of the project
  • Area of use, the number of floors, the total infrastructure, utilities, common areas, parking, etc.
  • Estimating project implementation costs for each of the options
  • Project execution schedule for each of the plan options
  • Economic review of project options
  • Determining the economic options of the plan for economic review (various options)

Phase one: Second stage: technical and economic studies


  • Assumptions of economic modeling and basics of cash flow
  • Sources and expenses table
  • Line graph of cash flow
  • Determination of the head-to-head point
  • Determination of IRR, NPV, PI
  • Financial analysis of the project and determination of the option with the most financial indicators: construction of the project with high-ranking criteria
  • Investigating project risk
  • Matching the options: selling land in the current state, obtaining a license and selling land with the obtained density, and building a project with high-level construction criteria.
  • Sensitivity analysis of the option with the highest financial index: construction of a project with high-ranking criteria
  • Financial and executive scheduling of the project
  • Breakdown table of project implementation costs
  • Financial scheduling - sale of the project
  • Project sale price breakdown table
  • Net inflow - outflow of cash, net comparison table of resources and expenses for all building models
  • Profitability comparison table of building models
  • Chart for determining the profit margin of the models
  • Investigating the effect of increasing building floors on profitability

Phase two: Building design of the project


  • Determining different models of project building design
  • Technical reviews of numerous construction models of the project
  • Economic reviews of numerous construction models of the project
  • The physical plan and structure of the initial formation of the architectural plan
  • Traffic analysis and design of parking lots
  • Summarizing and setting the final table of levels and uses of the architectural plan to be presented to the municipality
  • Making a mockup of the project
  • Mapping
  • Geotechnical studies and soil identification of the project land
  • Soil stabilizer structure design and excavation operation stages
  • Final design

Building Construction Assessment

Building Construction Assessment

  • Decades of  of engineering and executive experiences
  • Numerous completed project
  • University corporations
  • Over 1 milion square meters of constructed buildings
  • Experienced and highly educated teams in designings and field operations
Background
ICE Policy

Our projects are well known, and our engineers set us apart. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. ICE brings technical knowledge, experience, and resourcefulness to the delivery of our construction services. Our expertise and value-added offerings support our clients throughout the entire construction process.

We are committed to doing what is right—for our engineers, our clients, our communities, and our planet. We are building today to transform tomorrow through our unwavering commitments
  • Decades of  of engineering and executive experiences
  • Numerous completed project
  • University corporations
  • Over 1 milion square meters of constructed buildings
  • Experienced and highly educated teams in designings and field operations
Background
ICE Policy

Our projects are well known, and our engineers set us apart. At ICE, you will collaborate with engineers who share your passion for solving challenging problems and making a difference. ICE brings technical knowledge, experience, and resourcefulness to the delivery of our construction services. Our expertise and value-added offerings support our clients throughout the entire construction process.

We are committed to doing what is right—for our engineers, our clients, our communities, and our planet. We are building today to transform tomorrow through our unwavering commitments

Square Meters of ​Built Infrastructure

Finished projects

Years of Experience

Experties

Square Meters of ​Built Infrastructure

Finished projects

Years of Experience

Experties


The ICE
In the ICE, we’re always mindful of ensuring our clients are empowered and informed.
New Inovations
⦁ International and National Patents
⦁ Seismic Isolation
⦁ Design and Construction Methods
⦁ CRC Prefabricated Blocks
Learn More
Ocean Engineering
In partnership with Sharif University of Technology, we have been working for many years in designing and constructing marine structures with different applications in Iran.

ICE Group
We are a group of engineers who have been working for many years in designing and constructing buildings with different applications in Iran.
Structural Engineering and Construction
ICE design and implement of the latest and the most innovative engineering
Offshore Platforms
We provide the offshore and maritime industries with innovative platform design and construction, and engineering services.
Export
Based on the experiences we have gained, we decided to extend our field of activity to other countries and export designed and constructed structures that can be prefabricated.

The ICE
In the ICE, we’re always mindful of ensuring our clients are empowered and informed.
Offshore Structures
Seas greatly influence the earth's planet environment, while the ocean provides important living and nonliving resources. The ocean defines the feature of our planet and is crucial to life on earth.
PSS
Prefabricated steel structures (PSS) are similar in construction to conventional in-situ structures, but the parts are manufactured modularly under regulated conditions.

ICE Group
We are a group of engineers who have been working for many years in designing and constructing buildings with different applications in Iran.
Structural Engineering and Construction
ICE design and implement of the latest and the most innovative engineering
Offshore Platforms
We provide the offshore and maritime industries with innovative platform design and construction, and engineering services.
Export
Based on the experiences we have gained, we decided to extend our field of activity to other countries and export designed and constructed structures that can be prefabricated.
Copyright © 2024 ICE. All rights reserved.

CONNECT WITH US

GENERAL

English | فارسی

CONNECT WITH US

GENERAL

English | فارسی

Copyright © 2024 ICE. All rights reserved.
Copyright © 2024 ICE.
All rights reserved.
